1000L Brewery Project in Croatia

The brewery project of Brewtal Brew Co. began with an inquiry on November 29, 2023, from Croatia about 1000l beer brewing equipment. It involved multiple stages of communication:

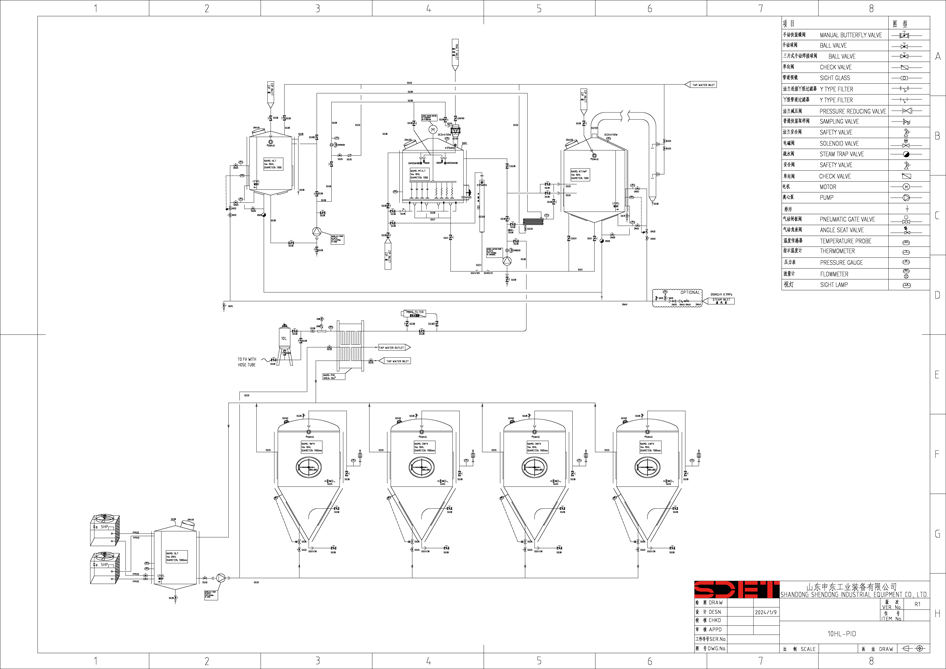

1. Brewing Process Confirmation (Nov. 29, 2023 – Jan. 9, 2024): 43 emails were exchanged over 40 days to finalize the brewing process and P&ID drawings.

2. Equipment Configuration (Jan. 9 – Feb. 2, 2024): 23 emails confirmed the 1000L beer brewing equipment configuration and layout design.

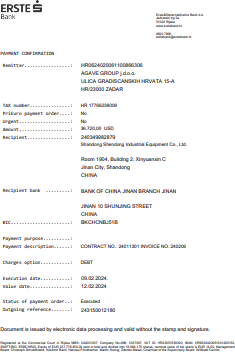

3. Final Configuration and Contract (Feb. 2 – Feb. 9, 2024): 9 emails confirmed the 1000L complete brewery details and configurations, discussed the details, signed the contract, and 40% deposit received.

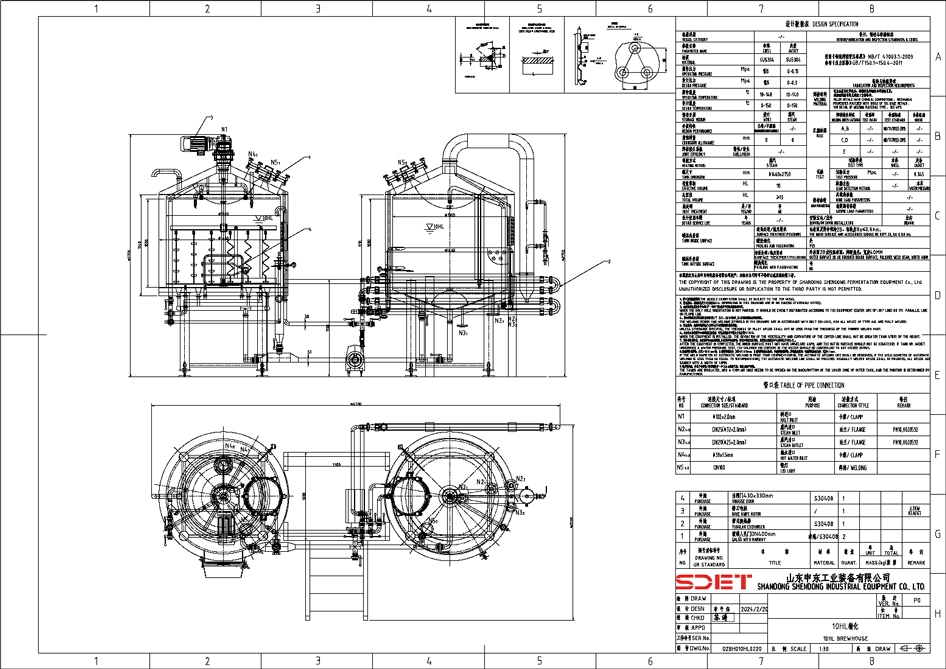

4. Drawings confirmation (Feb. 9 – Feb. 22, 2024): It took 13 days, coinciding with the Chinese New Year holiday, and through 7 emails, both parties completed the confirmation of all brewery tanks (1000l brewhouse, 1000l fermentation tank, 2000l glycol water tank, 100l two tanks CIP unit, 100l hop gun, etc.) production drawings, and the order was issued to the factory to start the production process.

5. Brewery equipment production (Feb. 22 – May 24, 2024): It took nearly 3 months to communicate the production progress through nearly 40 emails, and finally the equipment was loaded into the container and started the long journey from China to Croatia.

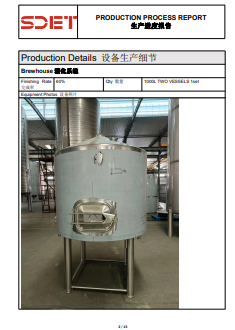

This is the biweekly production progress report:

This is a photo of the completion of the 1000L beer equipment:

This is a photo of the 1000L beer brewing equipment loaded into the container:

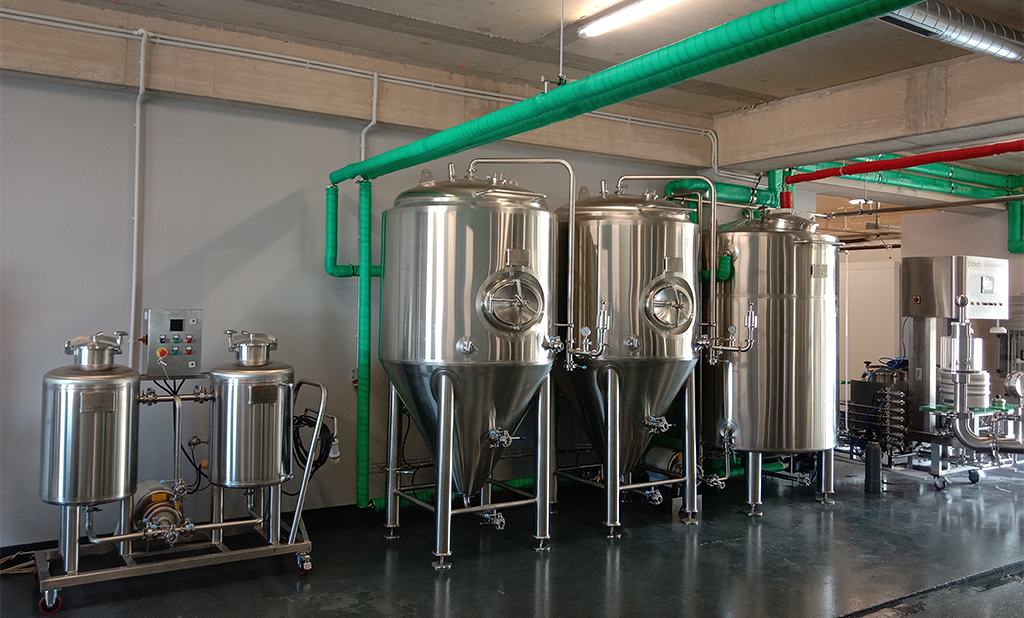

6. Assembly and Commissioning (Sep. 4 – Sep. 24, 2024): Equipment was successfully installed and commissioned at the customer’s factory in Zadar, Croatia.

The installation process went smoothly. I hope the customer’s beer business will get better and better.

If you are also interested in setting up a brewery, welcome to contact us for further information.
